Rate Tables Overview

Rate Tables associate Resource assignment components (Default Activity, Roles, and Resource attributes) with hourly rates. When a Resource assignment matches all the criteria in a Rate Table row, the corresponding hourly rate is applied. The rate is then used to calculate estimated and actual labor costs.

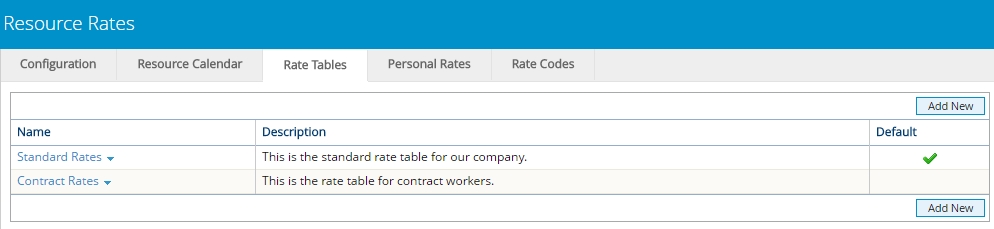

A PowerSteering environment can contain multiple Rate Tables.

Users can determine which Rate Table a work item will use while editing the work item's standard details.

Resource assignments must satisfy all components of a Rate Table's rate for it to be applied. Assignments that cannot completely fulfill any rates from the Rate Table will receive the default rate.

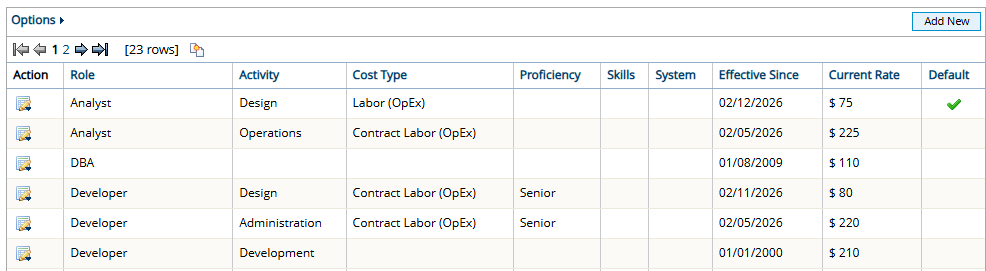

Example: Look at this rate from a project's designated Rate Table:

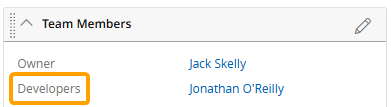

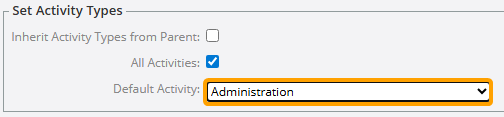

In order for this rate to be applied to an estimated or actual labor cost, the Resource must be assigned to the effort as a "Developer" and the work item's Default Activity must be set to "Administration".

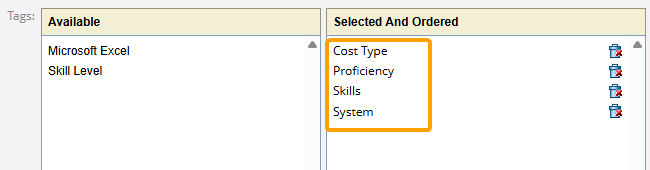

Additionally, the assigned Resource's Cost Type (the User Cost Tag) and Proficiency (Resource Qualification Tag) must be set to "Contract Labor (OpEx)" and "Senior", respectively.


If the assignment cannot satisfy all of these components, the rate will not be applied. If the assignment cannot satisfy any rates from the designated Rate Table, the Rate Table's default rate will be used to calculate the estimated labor cost.

Note: If a work item is configured to use Personal Rates, a Resource's Personal Rates will be applied before any rates from the designated Rate Table.

When this is the case, the designated Rate Table will only be used if the Resource does not have any Personal Rates.

Select any of the Rate Table attributes below for information on configuring them:

See the following pages for more information on Rate Tables:
